How Does Construction Waste Affect the Environment?

How much waste does UK construction actually produce?

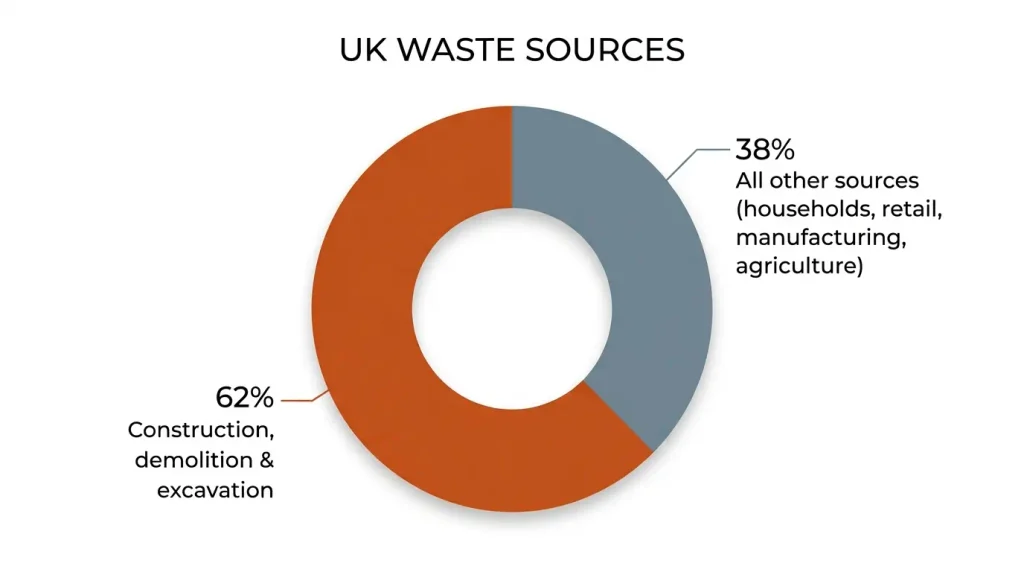

Construction, demolition and excavation generates around 123 million tonnes of waste a year in the UK. That is roughly 62% of everything the country throws away, from every source combined.

Households, retail, manufacturing and agriculture together account for the remaining third. Construction is not one contributor among many. It is the waste stream, and everything else is a rounding error beside it.

How much waste does UK construction actually produce

Those figures come from DEFRA’s UK Statistics on Waste, which publishes on a lag of several years, so the current position is likely to be broadly similar rather than precisely this. The scale is not in question either way.

The label covers three quite different problems, and grouping them hides more than it reveals:

  • Excavation waste, mostly soil and stone from groundworks. Enormous by weight, relatively benign, and often reusable on site if anyone plans for it.
  • Demolition arisings, meaning concrete, brick, timber, metals and whatever was built into a structure decades ago. Mixed, sometimes hazardous, and carrying an enormous amount of already-spent carbon.
  • New build and refurbishment waste, which is offcuts, damaged materials, over-ordering and packaging. Smallest by weight, and by some distance the most wasteful in the literal sense, because most of it was never used at all.

The direct environmental effects

The harms fall into four groups, and they operate at different ends of the process.

Landfill capacity and land take

Landfill void is finite and not being replaced. Inert construction waste is bulky, heavy and occupies space that cannot then be used for anything else.

As local sites close, waste travels further to reach the ones that remain, which adds a transport burden to a disposal problem. On large projects the haulage distance to an accepting site is now a genuine cost driver rather than an afterthought.

Soil and groundwater contamination

Not all construction waste is inert, and the parts that are not can leach.

Treated timber carries preservatives including copper and, in older material, arsenic and chromium. Old paints and coatings carry lead. Plant, generators and fuel storage introduce hydrocarbons. Where these end up in poorly managed disposal, the route into groundwater is through leachate, and the receptors are watercourses and aquifers rather than the site itself.

Why is plasterboard a problem in landfill?

Gypsum is the reason plasterboard has its own disposal rules.

When gypsum is landfilled alongside biodegradable waste, the sulphate in it reacts under anaerobic conditions to produce hydrogen sulphide. That is the rotten egg gas, it is toxic at concentration, and it is why plasterboard has been banned from mixed non-hazardous landfill in the UK for years. It has to go to a separate cell or, better, to a recycler.

Why is plasterboard a problem in landfill

Plasterboard is also one of the most commonly mishandled materials on small sites, because a sheet of it looks harmless and goes straight into the general skip. That one decision can contaminate an entire load and change how the whole skip is treated.

Dust, air quality and transport emissions

Site activity generates particulates. Cutting, breaking, grinding and vehicle movement all produce PM10, which matters most on urban sites near homes and schools.

Then there is the mileage nobody counts. Waste leaves site, goes to a transfer station, gets sorted, and moves again to its final destination. A tonne of mixed waste can travel a long way before it settles anywhere, and that transport footprint rarely appears in any project’s environmental reporting.

Extraction at the other end of the pipe

The impact people forget is at the beginning rather than the end.

Every tonne wasted is a tonne that had to be quarried, felled, fired or smelted first. Aggregate extraction is one of the larger land-use pressures in the UK, and it exists in proportion to demand. Waste inflates demand. The quarry is part of the waste problem even though nothing is thrown away there.

Hazardous waste and asbestos

Refurbishment of anything built before 2000 carries asbestos risk, in textured coatings, insulation board, cement sheet, floor tiles and pipe lagging.

Hazardous waste cannot be mixed with general waste, needs a consignment note rather than a standard transfer note, and has to go to a licensed facility. Mixing it in is both an environmental harm and an offence, and on domestic refurbishment it happens more often than the industry likes to admit.

Why is a 97% recovery rate misleading?

Here is where the standard account of construction waste falls apart.

Mineral construction and demolition waste in the UK is recovered at around 97%, excluding backfilling. On the face of it that looks like a solved problem. It is not, and the reason is that recovery, recycling and downcycling are three different things that get reported as one.

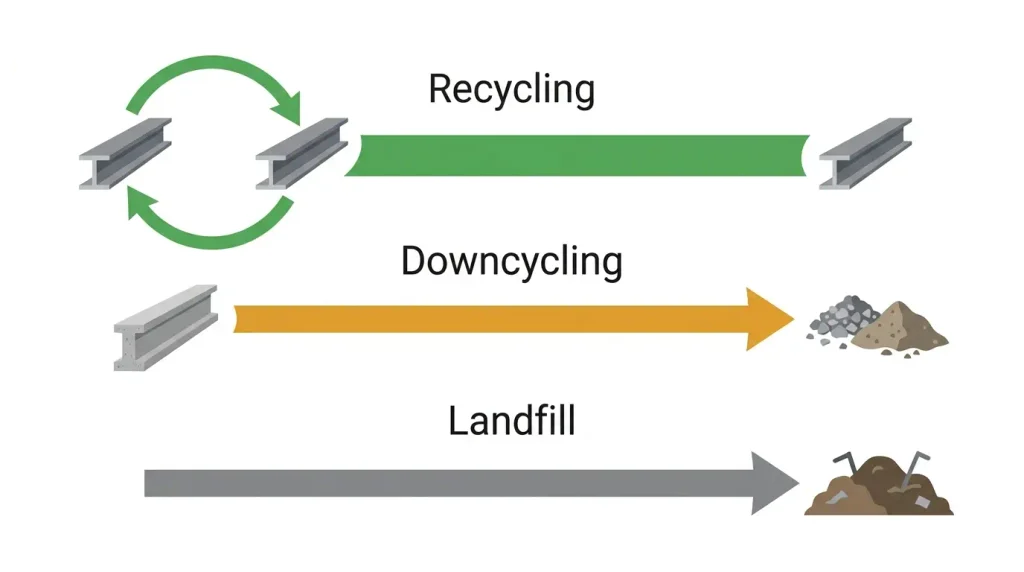

Recovery, recycling and downcycling

Recovery, recycling and downcycling

Recovery is the broadest term. It includes recycling, but also energy from waste and using material as backfill or engineering fill. A material can be recovered and still have left the economy permanently.

Recycling means the material genuinely re-enters use as a material. Steel is the standout here. Steel recycles into steel, effectively indefinitely, with no loss of grade.

Downcycling means it re-enters use at a permanently lower grade. It is better than landfill and it is not circular, because the loop only runs one way and it only runs once.

What happens to crushed concrete?

Almost all of it becomes sub-base, piling mat or general fill.

That is a real environmental benefit. It displaces virgin aggregate that would otherwise have been quarried, and it avoids landfill entirely. It should not be dismissed.

But a structural concrete beam that becomes road foundation has ended its useful life as a structural element. It will never be a beam again. The cement that gave it strength has done its work and cannot be recovered. So the 97% figure is not a measure of circularity, it is a measure of how much construction waste is heavy enough and inert enough to be crushed and used as fill.

Which materials actually do badly

The headline percentage is carried almost entirely by soil, concrete and rubble, because those dominate the tonnage. Weight-based reporting flatters the whole sector.

The materials with genuinely poor outcomes are lighter and therefore invisible in a tonnage figure:

  • Plasterboard, which is recyclable but frequently contaminated by mixing
  • Insulation, particularly rigid foam boards, which have very few recycling routes
  • Mixed and composite products, where materials are bonded and cannot be separated economically
  • Packaging, especially shrink wrap, banding and pallets on a site with no segregation
  • Engineered timber products, which contain adhesives that limit what can be done with them

Measure by weight and construction looks like a recycling success. Measure by material value or by carbon, and it does not.

The impact that never appears in the waste figures

Tonnage is the wrong unit for the biggest part of this problem.

Waste means paying the carbon twice

Every material on a site was quarried or grown, processed, transported, and installed. All of that spent energy is embodied carbon, and it is spent before the material ever reaches the building.

Throw the material away and none of that comes back. Then a replacement has to be manufactured, transported and installed, spending it all again.

So a skip of offcuts is not really a disposal problem. It is a manufacturing problem that already happened, and the environmental damage was done long before anything reached the skip. This is the reason waste prevention sits at the top of the hierarchy and recycling sits three places below it. Recycling manages a loss. Prevention avoids one.

Not all materials waste equally

Ten per cent over-ordering does very different amounts of damage depending on what it is.

Cement, steel, aluminium and rigid insulation carry high embodied carbon per kilogram. Over-ordering those is expensive environmentally. Timber, aggregate and plasterboard carry considerably less.

That has a practical consequence. If you can only be precise about a few things, be precise about the concrete, the steel and the insulation. Choosing lower-impact materials in the first place compounds the benefit, because the waste that does occur then carries less embodied carbon with it.

Demolition is the single biggest lever

The largest environmental decision on any project is made before anyone thinks about waste management at all. It is the decision to demolish or to retain.

Keeping an existing structure avoids the demolition waste and avoids the embodied carbon of everything that would have replaced it. No amount of careful site segregation on a new build comes close to the saving from not rebuilding in the first place, which is why refurbishment rather than replacement is now the default position in serious sustainability assessment.

The same logic applies at component scale. A green roof stripped off after eight years has not just created waste, it has wasted the entire carbon investment of building it. Longevity is a waste strategy.

What UK law requires you to do with construction waste

Three legal points matter, and most people on small projects know none of them.

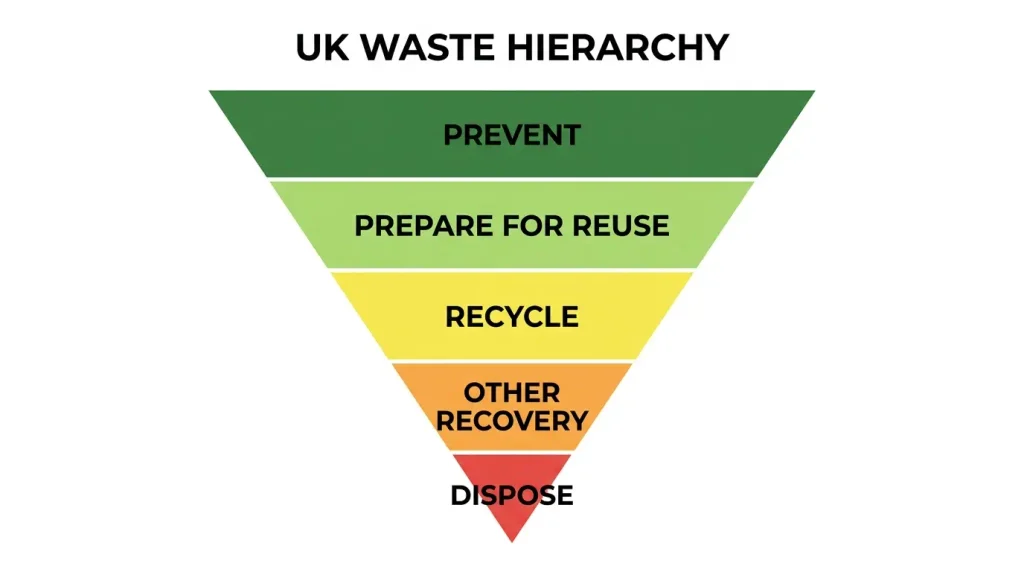

The waste hierarchy is a duty, not a suggestion

The waste hierarchy is a duty, not a suggestion

The hierarchy runs: prevent, prepare for reuse, recycle, other recovery, dispose. Under the Waste (England and Wales) Regulations 2011 there is a duty to apply it and to take reasonable steps to move waste up it.

In practice this is loosely enforced on small sites and taken seriously on larger ones. The principle is sound regardless of enforcement, and it is the right order to think in.

Can you be fined if your builder fly-tips your waste?

Yes, and this catches people out.

Under the Environmental Protection Act 1990 there is a duty of care over waste. If you pay someone to take waste away, you have to take reasonable steps to check they are authorised to do so, and you should keep a waste transfer note recording what was taken and by whom.

Where a contractor is carrying out the work and removing waste as part of the job, it is their waste and their duty. But where a householder arranges disposal directly, hiring a van to clear a skip’s worth of rubble, the householder duty of care applies. In England that can mean a fixed penalty notice, and on prosecution the fine is unlimited.

The cheap clearance quote is cheap for a reason often enough that the check is worth making.

How to check a waste carrier in two minutes

The Environment Agency keeps a public register of registered waste carriers, brokers and dealers. It is free, it is searchable by name or registration number, and it takes about two minutes.

Ask for the carrier’s registration number, check it, and keep the transfer note for two years. That is the whole obligation, and it is a low price for not being liable for whatever happens to the load.

What changed with landfill tax in April 2026

From 1 April 2026 the standard rate of landfill tax in England and Northern Ireland is £130.75 per tonne, up from £126.15.

The change that matters more for construction is the lower rate, which applies to inert waste such as soil, rock and rubble. It more than doubled, going from £4.05 to £8.65 per tonne. Scotland and Wales set their own rates through devolved equivalents.

For a project moving significant volumes of excavation material, that is a real increase in disposal cost, and it strengthens the case for reusing soil and hardcore on site rather than carting it away. Landfill tax is the largest single component of most gate fees, which is why disposal has become steadily more expensive while skip prices have risen faster than inflation. It is also why waste costs deserve a proper line in the preliminaries rather than an optimistic allowance.

Do you need a site waste management plan?

Not by law in England, though a lot of people still think you do.

Site waste management plans were mandatory for projects over £300,000 under regulations introduced in 2008, and those regulations were repealed in 2013. There is no longer a statutory requirement.

They remain standard practice, and they are frequently required by contract, by public sector clients, and by BREEAM assessments. Where one is produced, it sits naturally alongside the construction phase plan and covers much the same ground: what waste the project will produce, where it goes, and who is responsible.

What reduces construction waste in practice

Three things account for most of the achievable reduction, and they are all decided before the work starts.

Accurate ordering and setting out. Most site waste is material that was never used. Ordering to a measured take-off rather than a generous estimate, and setting out to minimise cuts, removes waste before it exists.

Designing to standard dimensions. Sheet materials, blocks and timber come in fixed sizes. A design that works with those sizes generates a fraction of the offcuts of one that ignores them. This is also where offsite and modern methods of construction earn their reputation, since factory conditions produce far less waste than a site does.

Segregating at source. A skip of mixed waste is treated as mixed waste. Separate the plasterboard, metals, timber and clean rubble on site and each stream goes somewhere useful. Segregation at the point of production is worth more than any sorting downstream, and it usually costs less too.

What reduces construction waste in practice

Two smaller ones worth naming: planning properly before work starts, so decisions are not reversed once materials are on site, and protecting existing finishes during the work, since a floor damaged by traffic becomes waste that nobody budgeted for.

There is considerably more to say about the practical side, and it has its own home. For the working detail on segregation, ordering, storage and site routines, see our guide to reducing construction waste on site.

Buon Construction works on renovations, extensions and commercial refurbishment across Nottingham and the East Midlands, and handles waste segregation and licensed disposal as part of the job rather than as an afterthought at the end of it.

FAQs

Is soil from excavation classed as construction waste?

Yes, and it is the largest single component by weight. Excavated soil and stone are classified as construction and demolition waste unless they are reused on the site they came from, which is why site reuse is treated as waste prevention rather than recycling. Contaminated soil is a separate category with stricter handling requirements.

Can you take construction waste to a household recycling centre?

Usually not, or only in small quantities and often for a charge. Most local authority sites classify building material as non-household waste and either refuse it or apply limits on rubble, soil, plasterboard and timber. Rules vary between councils, so check before loading a car. Waste from paid building work is the contractor’s responsibility regardless.

How much does it cost to dispose of construction waste in the UK?

An 8 yard builder’s skip runs roughly £250 to £320 in the north of England, more in the south and considerably more in London, with a street permit adding £15 to £60 where the skip cannot go on private ground. Heavy inert loads and contaminated or mixed waste both push the price up.

Is it cheaper to hire a skip or use a waste clearance service?

A skip is usually cheaper for a sustained project where waste accumulates over weeks. A clearance service often works out better for a single one-off load, particularly where there is nowhere to site a skip or a permit would be needed. Whichever you choose, check the carrier is registered and keep the paperwork.

What happens to waste after a skip is collected?

It goes to a transfer station, where it is tipped and sorted, mechanically and by hand. Metals, clean rubble, timber and cardboard are pulled out for recycling. What remains goes to energy recovery or landfill. Mixed skips recover far less than segregated ones, which is why sorting on site pays.

Does construction waste count towards a building’s carbon assessment?

Yes, in a whole life carbon assessment. Waste appears in the construction stage modules covering transport and waste processing, and material over-ordering shows up in the product stage, since anything purchased carries its embodied carbon whether or not it ends up in the building. Standard practice follows the RICS whole life carbon methodology.
